Supply-Chain Risk

Structural Shortage Spreading: CCL & Aluminum Electrolytics Upgraded to Red, MLCC Enters a Price-Hike Cycle, Copper Hits a Record High

Procurement Management Dept · Supply-Chain Market Intelligence · External Edition W35

Structural Shortage Spreading: CCL & Aluminum Electrolytics Upgraded to Red, MLCC Enters a Price-Hike Cycle, Copper Hits a Record High

Week 35 (W35) · Data as of August 27, 2026 · For hardware manufacturing, procurement & product teams

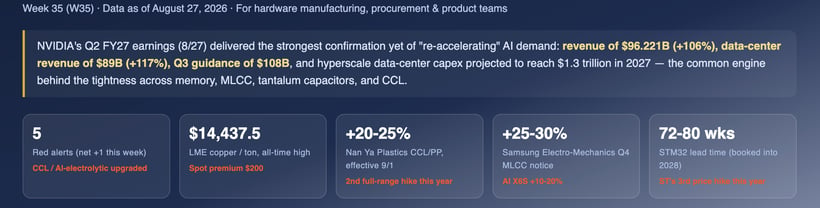

NVIDIA's Q2 FY27 earnings (8/27) delivered the strongest confirmation yet of "re-accelerating" AI demand: revenue of $96.221B (+106%), data-center revenue of $89B (+117%), Q3 guidance of $108B, and hyperscale data-center capex projected to reach $1.3 trillion in 2027 — the common engine behind the tightness across memory, MLCC, tantalum capacitors, and CCL.
5
Red alerts (net +1 this week)
CCL / Al-electrolytic upgraded
$14,437.5
LME copper / ton, all-time high
Spot premium $200
+20-25%
Nan Ya Plastics CCL/PP, effective 9/1
2nd full-range hike this year
+25-30%
Samsung Electro-Mechanics Q4 MLCC notice
AI X6S +10-20%
72-80 wks
STM32 lead time (booked into 2028)
ST's 3rd price hike this year
⏱ Price validity notice. Data assessed as of August 27, 2026 (W35) and typically remains valid for about one week in the current fast-moving market; several price-increase letters take effect in early September (see §9). Next issue: September 3, 2026 (W36). If you are reading this after September 3, please request the latest edition — ceramic capacitor and memory distributor quotes are already seeing "same-day expiry."

1Week-over-Week — Segment Changes & Driver Analysis

Comparison basis: W34 (Aug 13–20, 2026) vs W35 (Aug 20–27, 2026). This week, 9 segments / indicators registered significant changes; red alerts rose from 4 to 5, and no segment was downgraded — the shortage footprint is still expanding.

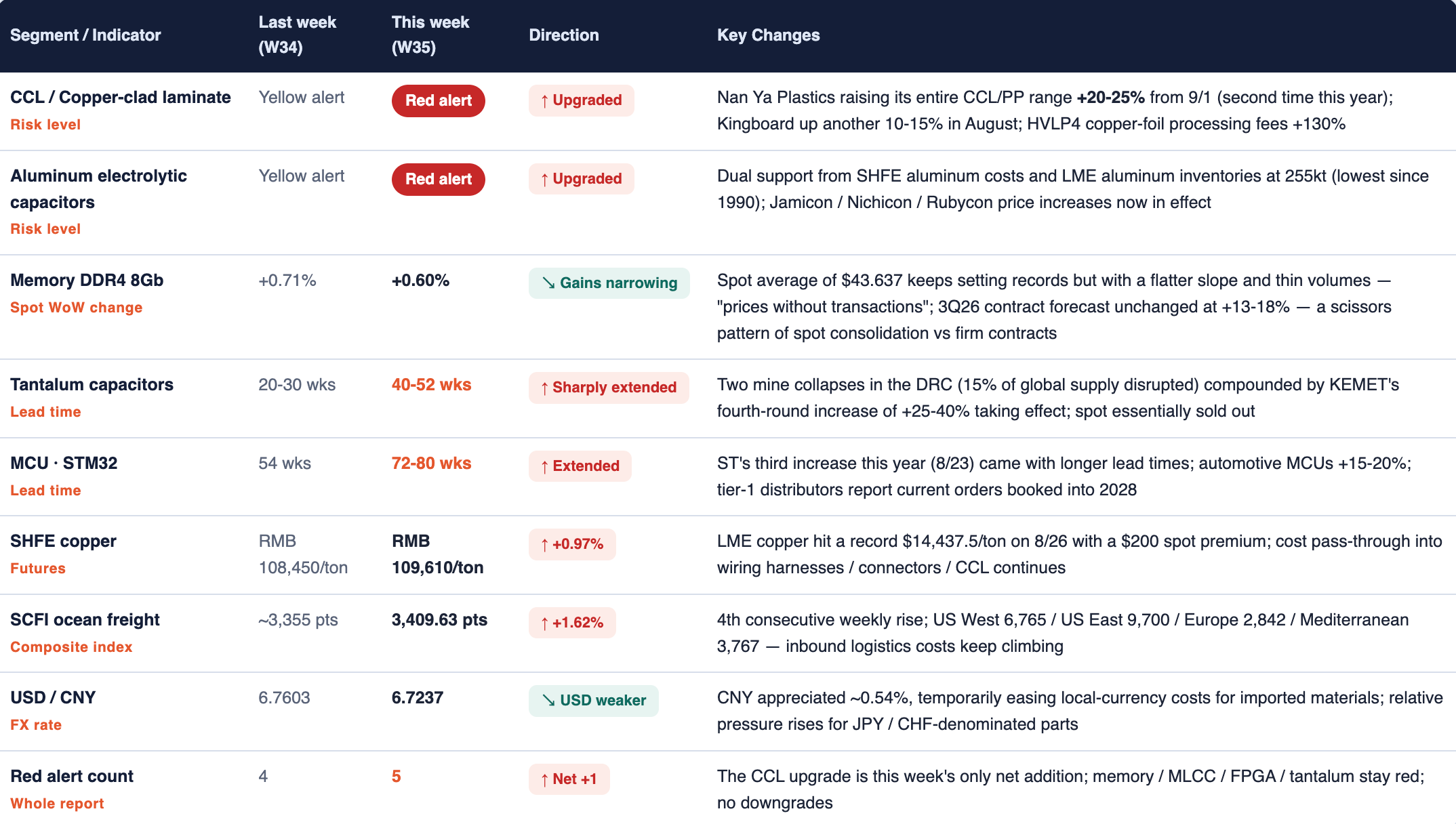

Segment / Indicator Last week (W34) This week (W35) Direction Key Changes
CCL / Copper-clad laminate
Risk level
Yellow alert Red alert ↑ Upgraded Nan Ya Plastics raising its entire CCL/PP range +20-25% from 9/1 (second time this year); Kingboard up another 10-15% in August; HVLP4 copper-foil processing fees +130%
Aluminum electrolytic capacitors
Risk level
Yellow alert Red alert ↑ Upgraded Dual support from SHFE aluminum costs and LME aluminum inventories at 255kt (lowest since 1990); Jamicon / Nichicon / Rubycon price increases now in effect
Memory DDR4 8Gb
Spot WoW change
+0.71% +0.60% ↘ Gains narrowing Spot average of $43.637 keeps setting records but with a flatter slope and thin volumes — "prices without transactions"; 3Q26 contract forecast unchanged at +13-18% — a scissors pattern of spot consolidation vs firm contracts
Tantalum capacitors
Lead time
20-30 wks 40-52 wks ↑ Sharply extended Two mine collapses in the DRC (15% of global supply disrupted) compounded by KEMET's fourth-round increase of +25-40% taking effect; spot essentially sold out
MCU · STM32
Lead time
54 wks 72-80 wks ↑ Extended ST's third increase this year (8/23) came with longer lead times; automotive MCUs +15-20%; tier-1 distributors report current orders booked into 2028
SHFE copper
Futures
RMB 108,450/ton RMB 109,610/ton ↑ +0.97% LME copper hit a record $14,437.5/ton on 8/26 with a $200 spot premium; cost pass-through into wiring harnesses / connectors / CCL continues
SCFI ocean freight
Composite index
~3,355 pts 3,409.63 pts ↑ +1.62% 4th consecutive weekly rise; US West 6,765 / US East 9,700 / Europe 2,842 / Mediterranean 3,767 — inbound logistics costs keep climbing
USD / CNY
FX rate
6.7603 6.7237 ↘ USD weaker CNY appreciated ~0.54%, temporarily easing local-currency costs for imported materials; relative pressure rises for JPY / CHF-denominated parts
Red alert count
Whole report
4 5 ↑ Net +1 The CCL upgrade is this week's only net addition; memory / MLCC / FPGA / tantalum stay red; no downgrades

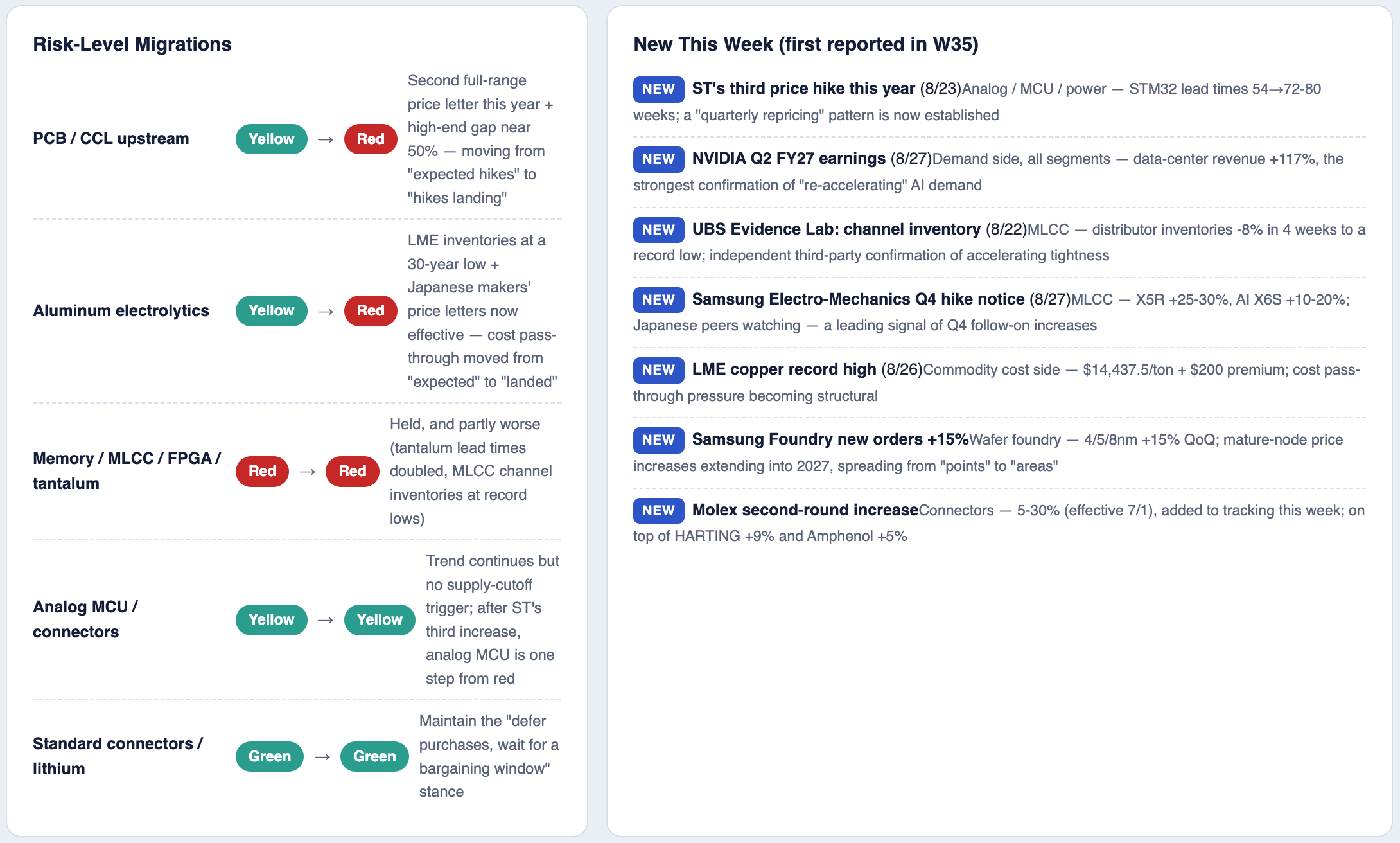

Risk-Level Migrations
PCB / CCL upstreamYellow→RedSecond full-range price letter this year + high-end gap near 50% — moving from "expected hikes" to "hikes landing"
Aluminum electrolyticsYellow→RedLME inventories at a 30-year low + Japanese makers' price letters now effective — cost pass-through moved from "expected" to "landed"
Memory / MLCC / FPGA / tantalumRed→RedHeld, and partly worse (tantalum lead times doubled, MLCC channel inventories at record lows)
Analog MCU / connectorsYellow→YellowTrend continues but no supply-cutoff trigger; after ST's third increase, analog MCU is one step from red
Standard connectors / lithiumGreen→GreenMaintain the "defer purchases, wait for a bargaining window" stance
New This Week (first reported in W35)
NEWST's third price hike this year (8/23)Analog / MCU / power — STM32 lead times 54→72-80 weeks; a "quarterly repricing" pattern is now established
NEWNVIDIA Q2 FY27 earnings (8/27)Demand side, all segments — data-center revenue +117%, the strongest confirmation of "re-accelerating" AI demand
NEWUBS Evidence Lab: channel inventory (8/22)MLCC — distributor inventories -8% in 4 weeks to a record low; independent third-party confirmation of accelerating tightness
NEWSamsung Electro-Mechanics Q4 hike notice (8/27)MLCC — X5R +25-30%, AI X6S +10-20%; Japanese peers watching — a leading signal of Q4 follow-on increases
NEWLME copper record high (8/26)Commodity cost side — $14,437.5/ton + $200 premium; cost pass-through pressure becoming structural
NEWSamsung Foundry new orders +15%Wafer foundry — 4/5/8nm +15% QoQ; mature-node price increases extending into 2027, spreading from "points" to "areas"
NEWMolex second-round increaseConnectors — 5-30% (effective 7/1), added to tracking this week; on top of HARTING +9% and Amphenol +5%

2Five Forces Driving the Market This Week

AI demand re-accelerating
NVIDIA data-center revenue +117%, Q3 guidance $108B; MLCC content per AI rack ~440k units (8-10× traditional), polymer tantalum 3,000-5,000 units, Rubin-rack PCB value +233%.
Rigid capacity constraints
High-end electronic-glass loom deliveries booked into 2028; high-end MLCC capacity cycles run 18-24 months with additions deferred to 2027; EUV export controls constrain advanced-node expansion.
Raw-material squeeze
LME copper at a record $14,437.5 + $200 spot premium; LME aluminum inventories at 255kt (lowest since 1990); two DRC mine collapses disrupting 15% of global tantalum supply.
Supplier price-hike cascade
Samsung Electro-Mechanics +30% already landed; Taiyo Yuden 9/1, Nan Ya Plastics CCL 9/1, ST's third round (8/23), KEMET's fourth round, ADI 9/13, Molex second round 5-30%.
FX & policy
CNY appreciation of 0.54% temporarily easing import costs; September FOMC rate-cut expectations (25bp); US export-control lists keep updating, restricting advanced-node equipment / EDA supply.

3Risk Heat Map — 13 Segments × Three Time Windows

Cell color = supply / price tightness. Bold outline = moved this week. Red = rising / high risk, green = falling / loose supply-demand (China market convention).

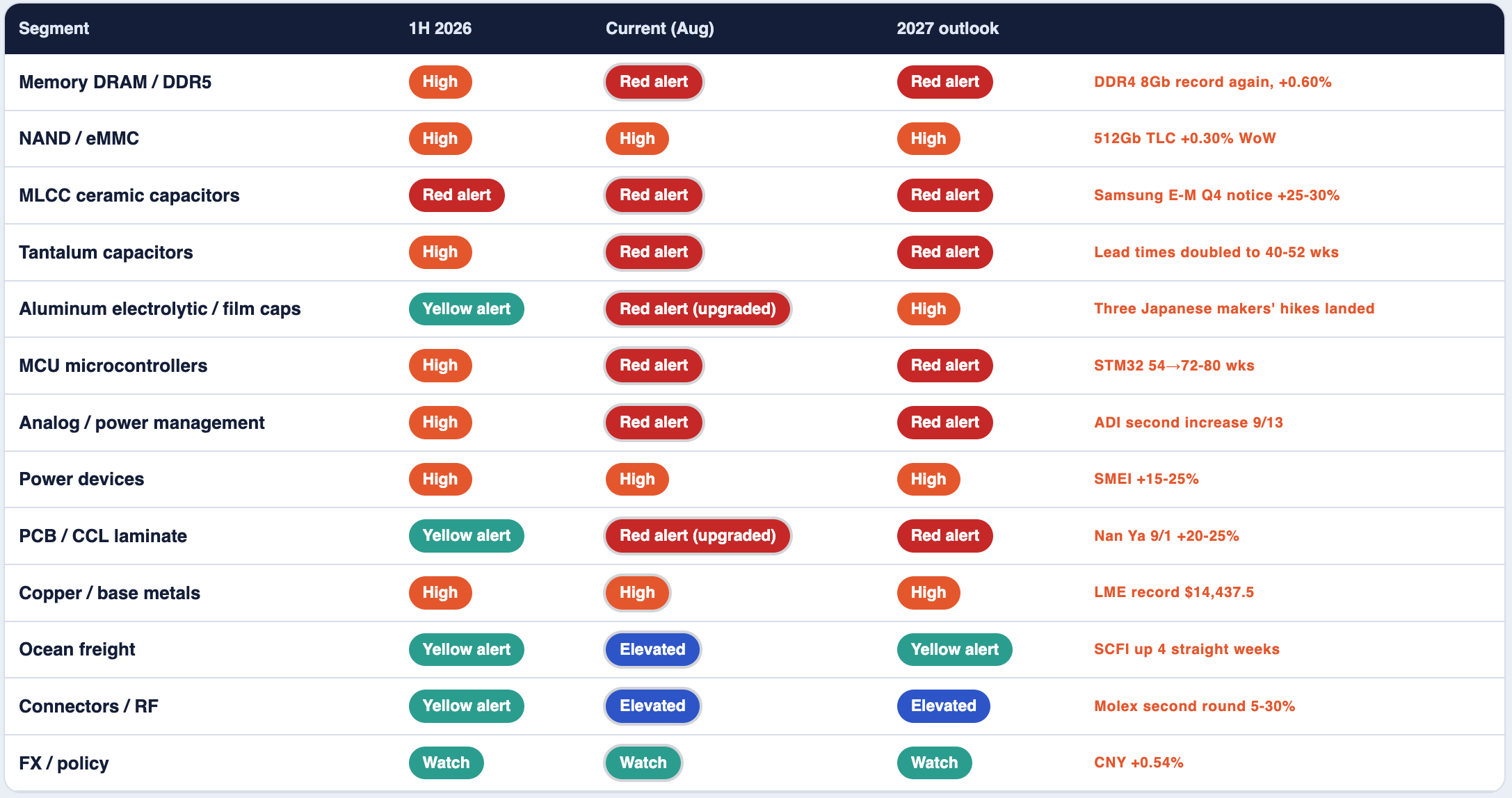

Segment 1H 2026 Current (Aug) 2027 outlook
Memory DRAM / DDR5 High Red alert Red alert DDR4 8Gb record again, +0.60%
NAND / eMMC High High High 512Gb TLC +0.30% WoW
MLCC ceramic capacitors Red alert Red alert Red alert Samsung E-M Q4 notice +25-30%
Tantalum capacitors High Red alert Red alert Lead times doubled to 40-52 wks
Aluminum electrolytic / film caps Yellow alert Red alert (upgraded) High Three Japanese makers' hikes landed
MCU microcontrollers High Red alert Red alert STM32 54→72-80 wks
Analog / power management High Red alert Red alert ADI second increase 9/13
Power devices High High High SMEI +15-25%
PCB / CCL laminate Yellow alert Red alert (upgraded) Red alert Nan Ya 9/1 +20-25%
Copper / base metals High High High LME record $14,437.5
Ocean freight Yellow alert Elevated Yellow alert SCFI up 4 straight weeks
Connectors / RF Yellow alert Elevated Elevated Molex second round 5-30%
FX / policy Watch Watch Watch CNY +0.54%

4Memory — Spot Consolidating at Highs, Contracts & End-Market Pass-Through in Sync

Spot prices keep setting records but on thin volumes — "prices without transactions"; 3Q26 DRAM contracts +13-18%, NAND +10-15%; Morgan Stanley sees Q3 DDR4 up another +50%.

100

Early 2026
baseline index
≈165

Electronic glass cloth 1080
YTD +120-168%
≈150

NAND 512Gb TLC
YTD +131-152%
≈420

MLCC high-cap 22μF+
YTD +320-520%
≈851

DDR4 8Gb
YTD +751%
THIS WEEK
Spot consolidating at highs: DDR4 8Gb spot average $43.637 (+0.60% WoW), 16Gb $91.049 (+0.54%) — new records on a flatter slope with thin volumes, extending the spot-vs-contract "scissors" pattern. Supply constraints deepening: SK hynix 2026-2027 capacity fully sold out; Samsung has moved 60-70% of sales onto LTAs that "cap downside, not upside"; OPPO / vivo have rejected Samsung's ~20% Q3 price offer. The constraint is shifting from price to allocation.

5PCB & Copper-Clad Laminate — Three Material Factors Resonating; a Seller's Market

The board itself — not just the components on it — has become the number-one cost driver.

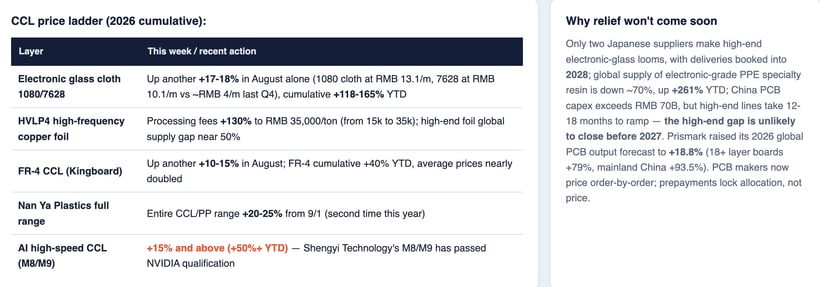

CCL price ladder (2026 cumulative):
Layer This week / recent action
Electronic glass cloth 1080/7628 Up another +17-18% in August alone (1080 cloth at RMB 13.1/m, 7628 at RMB 10.1/m vs ~RMB 4/m last Q4), cumulative +118-165% YTD
HVLP4 high-frequency copper foil Processing fees +130% to RMB 35,000/ton (from 15k to 35k); high-end foil global supply gap near 50%
FR-4 CCL (Kingboard) Up another +10-15% in August; FR-4 cumulative +40% YTD, average prices nearly doubled
Nan Ya Plastics full range Entire CCL/PP range +20-25% from 9/1 (second time this year)
AI high-speed CCL (M8/M9) +15% and above (+50%+ YTD) — Shengyi Technology's M8/M9 has passed NVIDIA qualification
Why relief won't come soon

Only two Japanese suppliers make high-end electronic-glass looms, with deliveries booked into 2028; global supply of electronic-grade PPE specialty resin is down ~70%, up +261% YTD; China PCB capex exceeds RMB 70B, but high-end lines take 12-18 months to ramp — the high-end gap is unlikely to close before 2027. Prismark raised its 2026 global PCB output forecast to +18.8% (18+ layer boards +79%, mainland China +93.5%). PCB makers now price order-by-order; prepayments lock allocation, not price.

6Segment-by-Segment Snapshot

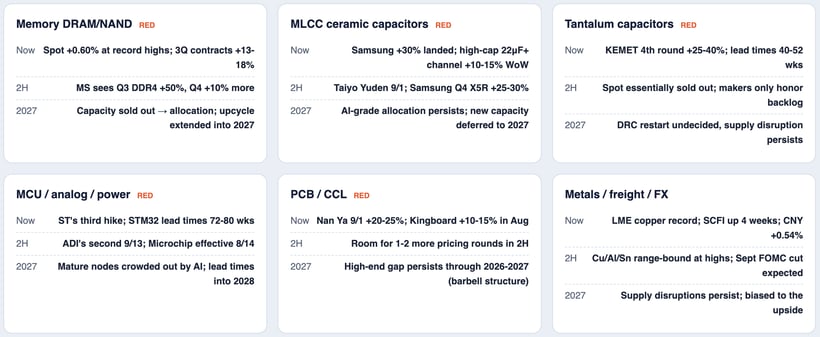

Memory DRAM/NAND RED

NowSpot +0.60% at record highs; 3Q contracts +13-18%
2HMS sees Q3 DDR4 +50%, Q4 +10% more
2027Capacity sold out → allocation; upcycle extended into 2027

MLCC ceramic capacitors RED

NowSamsung +30% landed; high-cap 22μF+ channel +10-15% WoW
2HTaiyo Yuden 9/1; Samsung Q4 X5R +25-30%
2027AI-grade allocation persists; new capacity deferred to 2027

Tantalum capacitors RED

NowKEMET 4th round +25-40%; lead times 40-52 wks
2HSpot essentially sold out; makers only honor backlog
2027DRC restart undecided, supply disruption persists

MCU / analog / power RED

NowST's third hike; STM32 lead times 72-80 wks
2HADI's second 9/13; Microchip effective 8/14
2027Mature nodes crowded out by AI; lead times into 2028

PCB / CCL RED

NowNan Ya 9/1 +20-25%; Kingboard +10-15% in Aug
2HRoom for 1-2 more pricing rounds in 2H
2027High-end gap persists through 2026-2027 (barbell structure)

Metals / freight / FX

NowLME copper record; SCFI up 4 weeks; CNY +0.54%
2HCu/Al/Sn range-bound at highs; Sept FOMC cut expected
2027Supply disruptions persist; biased to the upside

7This Week's Procurement Playbook — What to Do Now

A standing section, rewritten each week. Pull-in strategy runs in parallel with cost-reduction / substitution paths.

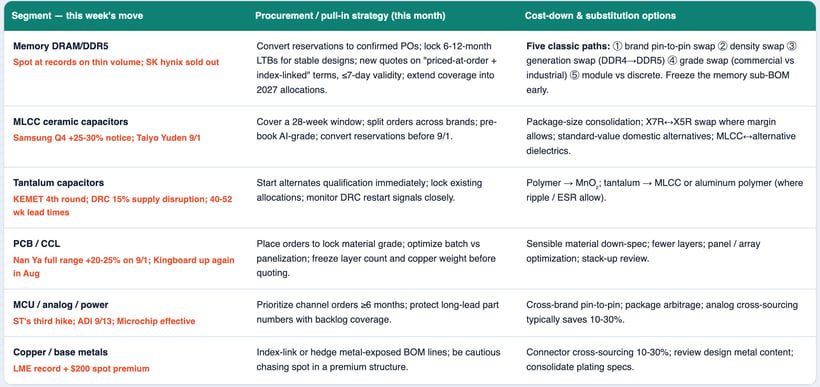

Segment — this week's move Procurement / pull-in strategy (this month) Cost-down & substitution options
Memory DRAM/DDR5Spot at records on thin volume; SK hynix sold out Convert reservations to confirmed POs; lock 6-12-month LTBs for stable designs; new quotes on "priced-at-order + index-linked" terms, ≤7-day validity; extend coverage into 2027 allocations. Five classic paths: ① brand pin-to-pin swap ② density swap ③ generation swap (DDR4→DDR5) ④ grade swap (commercial vs industrial) ⑤ module vs discrete. Freeze the memory sub-BOM early.
MLCC ceramic capacitorsSamsung Q4 +25-30% notice; Taiyo Yuden 9/1 Cover a 28-week window; split orders across brands; pre-book AI-grade; convert reservations before 9/1. Package-size consolidation; X7R↔X5R swap where margin allows; standard-value domestic alternatives; MLCC↔alternative dielectrics.
Tantalum capacitorsKEMET 4th round; DRC 15% supply disruption; 40-52 wk lead times Start alternates qualification immediately; lock existing allocations; monitor DRC restart signals closely. Polymer → MnO₂; tantalum → MLCC or aluminum polymer (where ripple / ESR allow).
PCB / CCLNan Ya full range +20-25% on 9/1; Kingboard up again in Aug Place orders to lock material grade; optimize batch vs panelization; freeze layer count and copper weight before quoting. Sensible material down-spec; fewer layers; panel / array optimization; stack-up review.
MCU / analog / powerST's third hike; ADI 9/13; Microchip effective Prioritize channel orders ≥6 months; protect long-lead part numbers with backlog coverage. Cross-brand pin-to-pin; package arbitrage; analog cross-sourcing typically saves 10-30%.
Copper / base metalsLME record + $200 spot premium Index-link or hedge metal-exposed BOM lines; be cautious chasing spot in a premium structure. Connector cross-sourcing 10-30%; review design metal content; consolidate plating specs.
↳ Alternates typically need a 6-12 week qualification cycle. Our market team maintains a pre-qualified cross-segment alternates list — the qualification clock is already running. See §11.

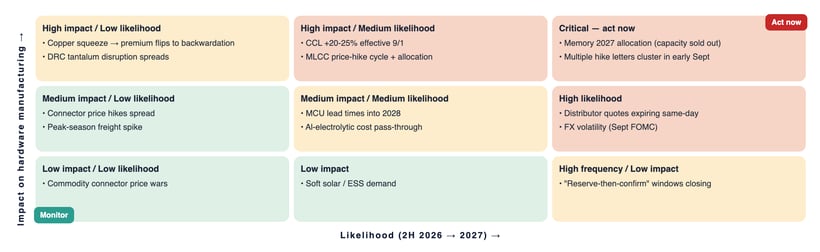

8Risk Matrix — Likelihood × Impact

Attention allocation: act immediately in the upper-right, keep monitoring in the lower-left.

Impact on hardware manufacturing →
Act now
Monitor
High impact / Low likelihood• Copper squeeze → premium flips to backwardation• DRC tantalum disruption spreads
High impact / Medium likelihood• CCL +20-25% effective 9/1• MLCC price-hike cycle + allocation
Critical — act now• Memory 2027 allocation (capacity sold out)• Multiple hike letters cluster in early Sept
Medium impact / Low likelihood• Connector price hikes spread• Peak-season freight spike
Medium impact / Medium likelihood• MCU lead times into 2028• Al-electrolytic cost pass-through
High likelihood• Distributor quotes expiring same-day• FX volatility (Sept FOMC)
Low impact / Low likelihood• Commodity connector price wars
Low impact• Soft solar / ESS demand
High frequency / Low impact• "Reserve-then-confirm" windows closing
Likelihood (2H 2026 → 2027) →

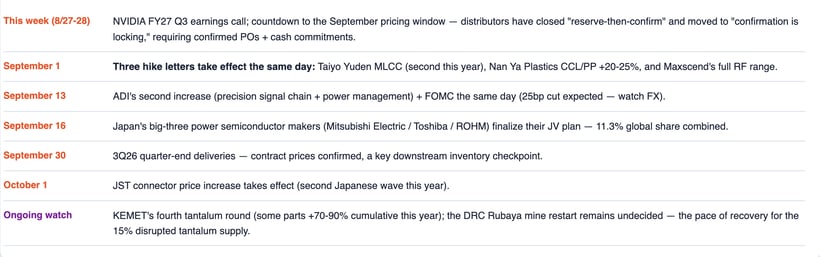

9Decision Timeline — Near-Term Windows & Key Dates

This week (8/27-28)
NVIDIA FY27 Q3 earnings call; countdown to the September pricing window — distributors have closed "reserve-then-confirm" and moved to "confirmation is locking," requiring confirmed POs + cash commitments.
September 1
Three hike letters take effect the same day: Taiyo Yuden MLCC (second this year), Nan Ya Plastics CCL/PP +20-25%, and Maxscend's full RF range.
September 13
ADI's second increase (precision signal chain + power management) + FOMC the same day (25bp cut expected — watch FX).
September 16
Japan's big-three power semiconductor makers (Mitsubishi Electric / Toshiba / ROHM) finalize their JV plan — 11.3% global share combined.
September 30
3Q26 quarter-end deliveries — contract prices confirmed, a key downstream inventory checkpoint.
October 1
JST connector price increase takes effect (second Japanese wave this year).
Ongoing watch
KEMET's fourth tantalum round (some parts +70-90% cumulative this year); the DRC Rubaya mine restart remains undecided — the pace of recovery for the 15% disrupted tantalum supply.

10Two Scenarios Looking Toward 2027

Base case — orderly escalation

Memory, MLCC, and CCL pass through in announced steps into 1H27; contract prices land as scheduled.
Copper stays range-bound at highs without a disorderly squeeze; freight normalizes seasonally.
Early lock-ins and index-linked orders gain cost visibility; unhedged BOMs get re-priced quarter by quarter.

Stress case — compounding shortages

Tantalum disruption spreads across the polymer-tantalum range; MLCC shifts from price hikes to allocation.
CCL sees 1-2 more rounds; copper spot premiums widen, a second metal cost pass-through.
Mature-node (MCU/analog) lead times stretch further; little relief before 2028.

What smart buyers are doing right now

1.Converting reservations into confirmed POs — allocation only honors confirmed orders; early September is the last window before the hikes.
2.All new quotes carry ≤7-day validity + index-linked clauses to prevent "confirmed-then-expired."
3.Qualifying alternates in parallel, so the 6-12-week substitution window is already open when needed.
4.Freezing PCB specs before quoting — layer count, copper weight, and panelization ahead of the hike letters.
5.Completing CCL / MLCC lock-ins and order conversions before 9/1.
6.Treating allocation (not price) as the planning variable for 2027 DRAM.

›What We Can Do for You

Real-time market intelligence
14 institutions, 6 major segments, 12 tracked part numbers; weekly updates + single-part deep dives to keep your team ahead of the curve.
Pre-qualified alternates
Cross-brand, cross-density, and domestic alternative options already validated — the 6-12-week qualification clock starts early, ready when you need it.
Stocking & LTB execution
Reservation-to-confirmation, multi-brand order splitting, structured last-time-buys — lock allocation first on constrained parts.
Design cost-down reviews
PCB spec-freezing, BOM consolidation, package arbitrage — hedging the impact of price pass-through on your costs.

§Data Sources

Legend. Red = rising / high risk, green = falling / loose supply-demand (China market convention). [Institutional] = public institutional data; [Channel-verified] = anonymous distributor / agent feedback; [Industry brief] = industry events & vendor materials. Categories with "no change this week" are explicitly marked.
Tightness: Yellow alert Elevated High Red alert
Procurement Management Dept · Supply-Chain Market Intelligence · Weekly External Edition W35 · Data as of August 27, 2026 · Next issue September 3, 2026 · This report is compiled from public information and industry research for supply-chain and procurement decision support only; it does not constitute investment advice or a basis for external quotations.
